PS Exam Preparation

Comprehensive preparation for the NCEES Principles and Practice of Surveying (PS) exam. 5 modules covering all 5 exam domains with 50 in-depth topics.

Progress0/50
Lesson 1

Project Planning & Management

Learning Objectives

After completing this topic, you should be able to:

  • Develop a comprehensive project plan for surveying engagements
  • Apply project management methodologies to survey projects
  • Create and manage project schedules using standard techniques
  • Identify project deliverables and milestones
  • Allocate resources effectively across concurrent projects
  • Recognize common causes of project failure and apply preventive measures

Overview

Project planning is the foundation of every successful surveying engagement. Before any field crew mobilizes, the project manager must define the scope, estimate resources, establish a schedule, and identify risks. Poor planning leads to cost overruns, missed deadlines, dissatisfied clients, and potential liability exposure.

The PS exam tests your ability to apply structured project management principles to real surveying scenarios -- not abstract management theory, but the practical decisions that determine whether a project succeeds or fails.


Key Concepts

Figure PS.4.1 — Survey Project Life Cycle

The Project Life Cycle

Every survey project follows a predictable life cycle, regardless of size or complexity:

PhaseActivitiesKey Outputs
InitiationClient contact, site reconnaissance, scope discussionProposal, contract
PlanningResearch, scheduling, resource allocation, risk assessmentProject plan, schedule
ExecutionField operations, data collection, office computationsRaw data, field notes
DeliveryMap preparation, report writing, QA/QC reviewFinal deliverables
CloseoutClient review, file archiving, lessons learnedArchived project file

Scope Definition

Scope definition is arguably the most important step in project planning. An ambiguous scope leads to disputes, scope creep, and unprofitable projects.

Elements of a Well-Defined Scope:

  • Geographic extent -- The specific property or area to be surveyed, identified by legal description, address, or coordinates
  • Survey type -- Boundary, topographic, ALTA/NSPS, construction layout, control, or other
  • Standards -- Which standards apply (state minimum standards, ALTA/NSPS, local ordinances)
  • Deliverables -- Maps, plats, reports, digital files, staking, monuments
  • Exclusions -- Work explicitly not included (environmental assessment, title search, utility locating)
  • Assumptions -- Conditions assumed to be true (access available, monuments in place, clear weather)

Defining Deliverables

Deliverables must be specific enough that both parties can agree on whether they have been provided:

Vague DeliverableSpecific Deliverable
"A survey""Boundary survey plat showing all found and set monuments, bearing and distance of all boundary lines, basis of bearings, area, and adjoining owner information"
"Topo map""Topographic survey at 1-foot contour interval, showing all visible improvements, utilities, and vegetation within the property limits, delivered as AutoCAD .dwg file"
"Staking""Offset stakes at 50-foot intervals along proposed centerline with cut/fill to finish grade, plus all horizontal and vertical curve points"

Project Scheduling

Work Breakdown Structure (WBS)

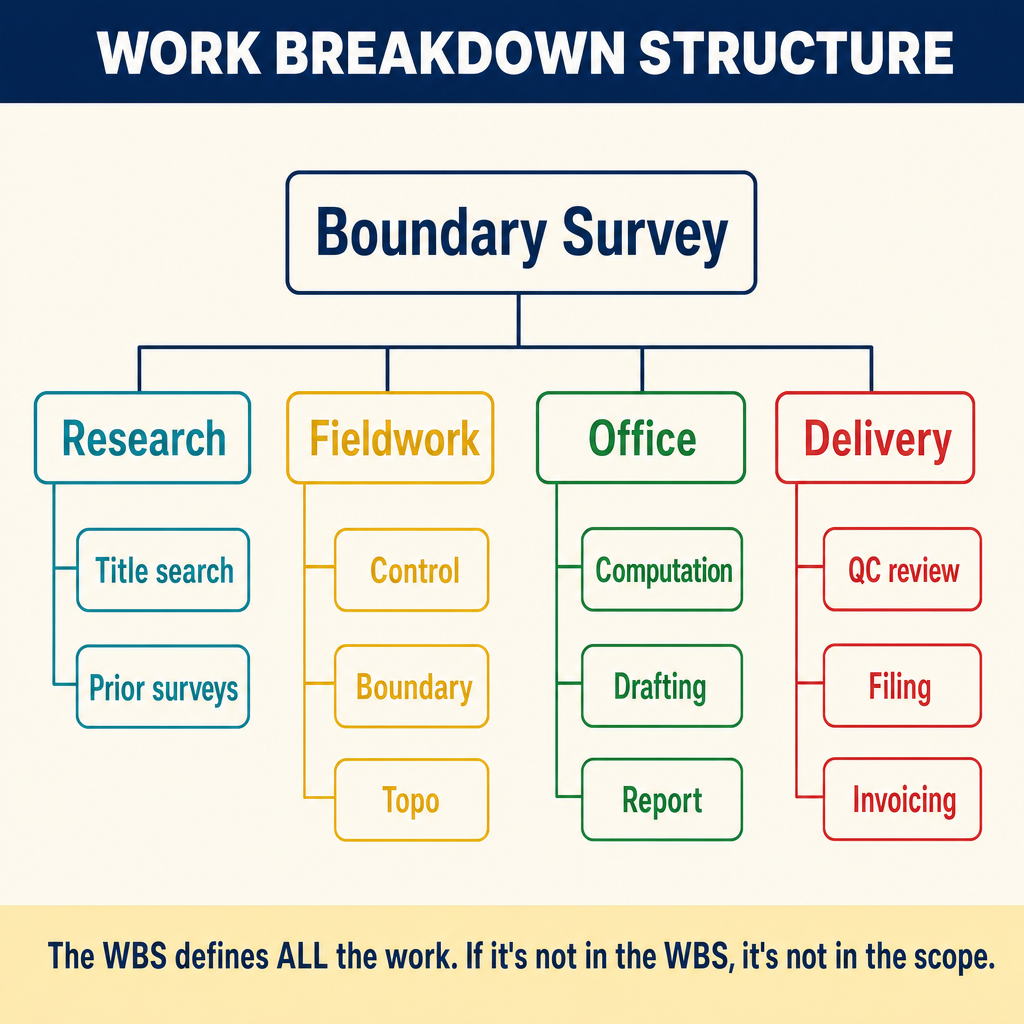

Figure PS.4.9 — Work Breakdown Structure for a boundary survey

A Work Breakdown Structure decomposes the project into manageable tasks. For a typical boundary survey:

Level 1: Boundary Survey Project

Level 2 tasks:

  1. Research and preparation
  2. Field survey
  3. Office computations
  4. Map preparation
  5. QA/QC review
  6. Client delivery

Level 3 tasks (under Field Survey):

  • Mobilization and site access
  • Control establishment
  • Monument search and recovery
  • Boundary evidence collection
  • Topographic data (if included)
  • Demobilization

Scheduling Methods

Critical Path Method (CPM)

CPM identifies the longest sequence of dependent tasks, which determines the minimum project duration. Any delay on the critical path delays the entire project.

For a boundary survey, the critical path typically runs: Research --> Field Survey --> Computations --> Map Preparation --> Review --> Delivery

Tasks that can proceed in parallel (such as title research while field equipment is being prepared) are not on the critical path and have "float" -- they can be delayed without affecting the project completion date.

Gantt Charts

Gantt charts display tasks as horizontal bars on a timeline. They are the most common scheduling tool in surveying practice because they are intuitive and easy to update.

Key elements of an effective Gantt chart:

  • Task names and durations
  • Dependencies between tasks
  • Milestones (contract execution, field complete, delivery date)
  • Resource assignments
  • Progress indicators

Estimating Task Durations

Duration estimates should be based on historical data whenever possible. Common factors affecting survey task durations:

FactorImpact on Duration
TerrainSteep, heavily vegetated, or urban sites take longer
AccessRemote sites require mobilization time; restricted access limits work windows
DensityMore points, more monuments, more detail means more time
WeatherSeasonal conditions may limit productive field days
ComplexityConflicting records, disputed boundaries, and unusual geometries add research and analysis time
Crew experienceLess experienced crews need more time and supervision

Resource Allocation

Personnel

Survey projects require different skill sets at different phases:

PhasePersonnel Needed
ResearchProject surveyor, research technician
FieldParty chief, instrument operator, rod person(s)
ComputationsProject surveyor, CAD technician
Map preparationCAD technician, drafting specialist
QA/QCSenior surveyor or peer reviewer
DeliveryProject surveyor, licensed surveyor (for seal)

When managing multiple concurrent projects, the project manager must balance personnel across projects to avoid bottlenecks. The licensed surveyor responsible for sealing work products is often the most constrained resource.

Equipment

Equipment allocation requires advance planning:

  • Total stations and GNSS receivers -- Schedule shared equipment across crews
  • Specialty equipment -- Laser scanners, hydrographic sonar, UAVs may need advance booking
  • Vehicles -- Fleet management for field crews
  • Software licenses -- Some software is seat-limited

Budget vs. Schedule Trade-offs

Project managers frequently face trade-offs between cost and schedule:

ApproachCost ImpactSchedule Impact
Add a second field crewHigher labor costFaster field completion
OvertimePremium pay ratesModerate acceleration
Reduce scopeLower costShorter schedule
Accept delayNo additional costLonger schedule

The right choice depends on contract terms, client needs, and firm capacity.


Project Monitoring and Control

Progress Tracking

Effective project managers track progress against the plan:

  • Percent complete by task and overall
  • Budget consumed vs. budget remaining
  • Schedule variance -- ahead or behind plan
  • Scope changes -- documented and approved

Earned Value Management

Earned Value Management (EVM) integrates scope, schedule, and cost data:

MetricFormulaMeaning
Planned Value (PV)Budgeted cost of work scheduledWhat you planned to spend by now
Earned Value (EV)Budgeted cost of work performedValue of work actually completed
Actual Cost (AC)Actual cost of work performedWhat you actually spent
Cost Variance (CV)EV - ACPositive = under budget
Schedule Variance (SV)EV - PVPositive = ahead of schedule
Cost Performance Index (CPI)EV / ACGreater than 1.0 = under budget
Schedule Performance Index (SPI)EV / PVGreater than 1.0 = ahead of schedule

While full EVM is more common on large public projects, the underlying concepts apply to any surveying engagement.

Change Management

Scope changes are inevitable. A disciplined change management process includes:

  1. Identify the change and its cause
  2. Document the change request in writing
  3. Assess the impact on scope, schedule, and budget
  4. Approve (or reject) the change with client authorization
  5. Implement the change
  6. Update the project plan, schedule, and budget

Undocumented scope changes are a leading cause of unprofitable projects and client disputes.

Common wrong path — "scope creep is inevitable, just absorb it." When a client asks for "one more thing" during a project, it's tempting to accept the task without formal change management, especially for small additions from good clients. This is the primary path to unprofitable projects and fee disputes. Every added task takes time, and "small" additions accumulate — five "quick" add-ons may total 30 hours of uncompensated labor. The right response to every scope change, regardless of size, is: acknowledge, document in writing, assess impact, get written authorization (or rejection), then proceed. Documenting a fifteen-minute phone-call request takes five minutes; not documenting it can cost thousands in disputes months later. Exam questions test this by presenting a client request that seems minor — the correct answer is always to document and obtain authorization, not "just do it" to keep the client happy. Scope creep is not inevitable; failure to manage it is inevitable if you don't have a process.

Quick retrieval check — try before reading on.

During an ALTA survey, the client calls and asks you to "also locate that retaining wall along the south property line while you're out there" — it's about 300 ft long and not part of the original Table A requests. The field crew has not yet demobilized. What is your immediate response, and what must you do to address this properly?

Do not just add it to the field work. Respond with: "Sure, I can add that — let me prepare a brief change-order email confirming the additional scope, the estimated fee, and the impact on delivery date. Once you approve it in writing, we'll proceed."

Why: even a seemingly small addition (300 ft of retaining wall location) has real costs — additional field time, additional office time to depict it, potential need for additional Table A item documentation, and increased deliverable complexity. Absorbing the work without authorization violates your change management process and exposes you to (a) reduced profit on the project, (b) fee disputes at invoicing time if the client doesn't remember authorizing it, (c) ALTA certification issues if the added feature requires a Table A item that was not in scope. Document, price, obtain written authorization, then proceed. This takes 10 minutes of email work and saves hours of disputes later.


Common Causes of Project Failure

Planning Failures

  • Inadequate research -- Discovering conflicting records mid-project
  • Unrealistic schedule -- Promising delivery dates without considering constraints
  • Poor scope definition -- Client expectations exceed what was agreed
  • Insufficient site reconnaissance -- Unexpected field conditions

Execution Failures

  • Resource conflicts -- Key personnel pulled to other projects
  • Equipment failure -- No backup plan for critical equipment
  • Weather delays -- No contingency in the schedule
  • Communication breakdown -- Field crew and office not coordinated

Delivery Failures

  • Inadequate QA/QC -- Errors discovered after delivery
  • Missing client expectations -- Deliverables do not match client needs
  • Late delivery -- Missed deadlines damage client relationships

Project Documentation

The Project File

A complete project file should contain:

CategoryContents
AdministrativeContract, correspondence, invoices, change orders
ResearchTitle reports, recorded documents, prior surveys
FieldField notes, raw data, photographs, control data
ComputationsAdjustment reports, coordinate files, calculation sheets
DeliverablesFinal maps, reports, legal descriptions
QA/QCReview checklists, correction logs

Retention Requirements

Project files must be retained according to:

  • State board requirements (varies by jurisdiction)
  • Statute of limitations for professional liability
  • Client contract requirements
  • Firm policy (often 10-15 years minimum)

Exam Tips

  • The PS exam frequently presents scenarios where you must identify the next logical step in a project sequence -- know the project life cycle phases
  • Questions about scheduling often test whether you understand task dependencies and critical path concepts
  • Scope definition questions test whether you can distinguish between complete and incomplete scope statements
  • Resource allocation questions may present competing priorities across multiple projects
  • Change management questions test whether you follow proper documentation and approval procedures

Related Test Topics

  • Costs, Budgets, and Contracts (Topic 4.2)
  • Survey Types and Scope of Services (Topic 4.3)
  • Quality Assurance and Quality Control Methods (Topic 4.5)
  • Risk Management (Topic 4.6)
  • Client Communication and Interdisciplinary Coordination (Topic 4.8)

Further Reading

Authoritative sources for deeper study


Last updated: 2026-04-17
